Concrete Calculator – Volume, Bags, Yards & Cost
Plan Your Concrete Pour & Order Quantity
Add your pours, enter dimensions, and see the concrete you need to order.
Build Your Concrete Project
1. Project & measurement setup
2. Project sections
i
Name each pour, select the shape that represents the space concrete will fill, then enter dimensions and units. Use Add concrete for new pours and Deduction / void to subtract real empty space. The diagram beside each section result helps confirm the geometry.
Examples: a circular solid slab is a short cylinder (round shape with slab thickness as height). For a hollow circular ring choose Tube / ring. Solid steps are different from supported structural stair flights. For a variable-thickness ramp, use its verified measured volume if a suitable ramp shape is unavailable.
3. Order allowance
Editable planning allowance for uneven grade, form variation, spillage or placement loss. It is not a structural safety factor.
A planning default only. Replace it with your supplier’s actual ordering increment.
4. Ready-mix supplier & cost settings
Supplier delivery minimums, short-load billing rules, truck sizes and rounding vary. Enter actual supplier rules. A minimum billed volume is not necessarily a minimum delivered volume.
5. Premix bag settings
Use the yield printed on the exact bag or product data sheet. Bag weight alone does not reliably determine mixed-concrete volume.
Concrete order result
Calculation steps with your values
Quick volume converter
Your take-to-the-store checklist
Concrete Order Summary
Your final purchasing checklist. Choose one supply option below and verify quantities before buying.
Project sections and deductions
| # | Section | Shape | Qty | Use | Volume (m³) | Volume (yd³) |
|---|
A. Delivered ready-mix concrete
B. Premixed concrete bags
Use the exact bag product and its stated mixed yield. Bag quantities are a separate alternative to ordering ready-mix.
C. Buy cement, sand & aggregate separately
Prefer to mix materials on site? Select a nominal planning ratio or enter your approved proportions. Your estimated shopping quantities will appear below.
Enter your material-mixing ratio
Planning assumption; adjust to your estimating method.
Leave blank unless supplied by your approved mix/design basis.
Important: nominal ratios are estimating examples, not strength guarantees. For M25/M30 and other design-mix concrete, use approved project or supplier proportions.
Important: A 1 : 2 : 3 ratio describes proportions by volume—not automatically one bag of cement plus two bags of sand and three bags of stone. The result gives cement mass / estimated 50 kg cement bags and sand and aggregate volumes. Supplier bag sizes, loose-material bulk densities and moisture differ; verify them before ordering. Mix proportions do not certify concrete strength.
🔗 Share, save & reopen your concrete project
📷 See the concrete examples — pictures (open by default)
These reference photos support the calculator. They are illustrations, not project-specific drawings. You can collapse the entire picture guide whenever you prefer more space.




Assumptions & Limitations
These estimates depend on the dimensions, units, mix proportions, bag-yield and supplier information you provide. Please review the points most relevant to your purchase.
📐 Measurements & geometry
Dimensions are assumed to describe the actual volume to fill. Slabs are treated as uniform-thickness solids. Round shapes and tube/ring sections use the indicated geometry. Variations in ground level, excavation, irregular profiles, embedded members and unmodelled voids are not automatically measured.
➕ Allowance & deductions
Percentage allowance is applied to the calculated net volume. It is a user-selected planning allowance, not a guaranteed waste percentage or structural safety factor. Only the deductions that you enter are subtracted. Inspect all dimensions and ensure no area is counted twice.
🧱 Bags & supplier ordering
Bag count is rounded upward using the actual mixed yield of the selected product. Supplier order increment, minimum load, vehicle capacity, prices and extra charges vary and must be confirmed directly. A supplier minimum billed quantity can differ from the concrete actually delivered.
🪨 Mixing your own ingredients
Nominal volumetric ratios estimate cement, sand and coarse aggregate quantities using assumed dry-volume and bulk-density factors. They do not account automatically for aggregate grading, moisture correction, air content, admixtures, mixing losses or strength verification. Water demand and structural performance require an approved mix/design basis.
🛠️ Practical site considerations
Allow for safe formwork, compaction, reinforcement and cover, site access, truck/pump availability, labor, placing sequence, weather, curing, quality control and local regulations. These are not checked by the volume calculation.
✅ Before making a payment
Compare measurements with approved drawings and actual site conditions, confirm the concrete specification, ask suppliers for written product yields and quotation terms, and have a qualified professional review structural or safety-critical work.
Concrete Calculator Questions
Every question expands into a practical, worked explanation. The answers stay collapsed until you want to read them; all photo guides remain visible by default.
How much concrete do I need?

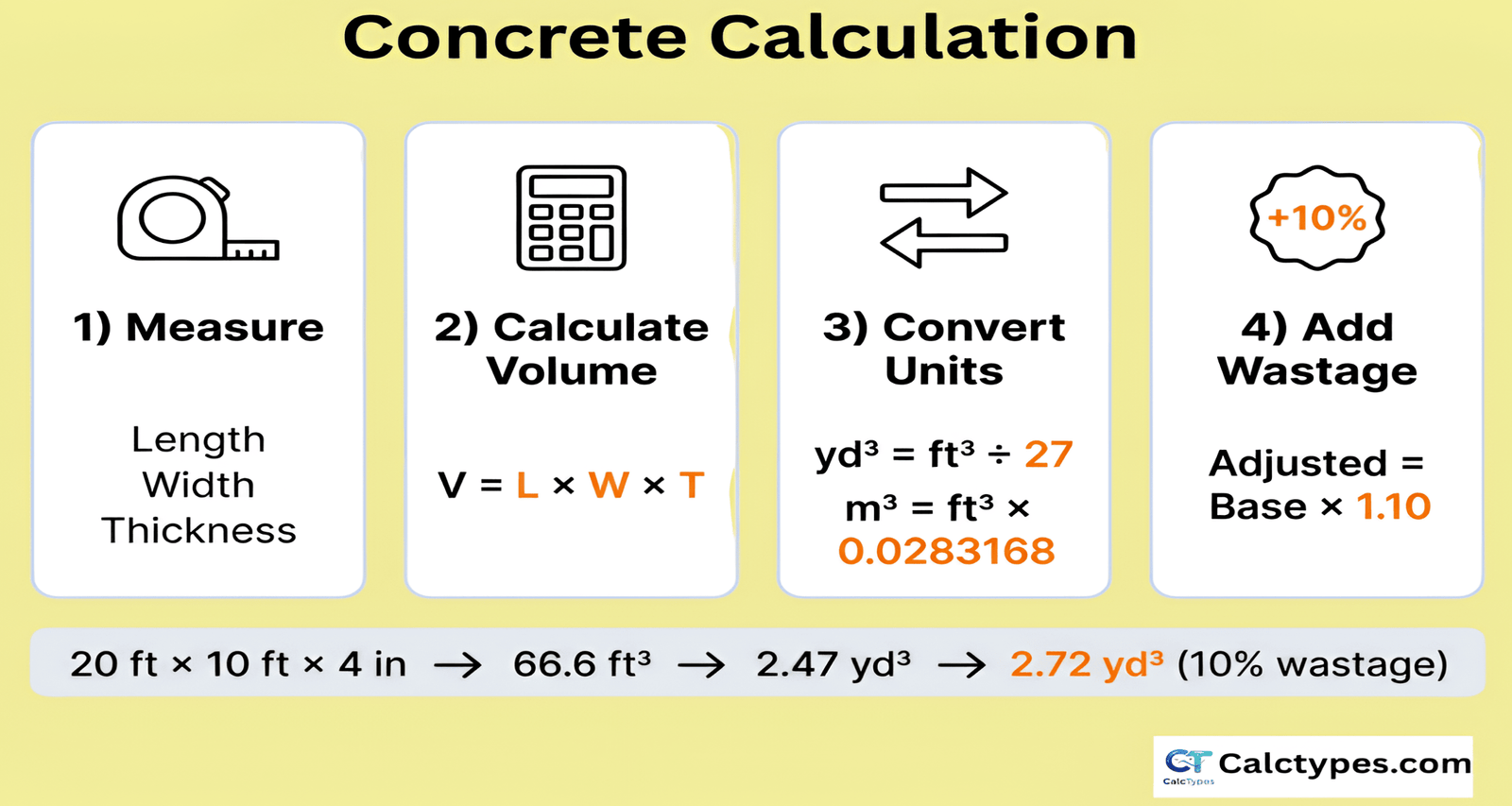

Multiply length × width × thickness in the same units (for example 10 ft × 10 ft × 0.33 ft ≈ 33 ft³, or about 1.23 yd³), then add 5–10% extra.
Start with the actual space the finished concrete must occupy, not the outside size of the job. For a rectangular slab, measure length × width × thickness. For a solid round column, measure diameter and height. For a project with several pours, add a section for each one, use Quantity for identical pieces, and subtract openings or voids only when they really remove concrete from the measured volume.
Worked example: a 10 ft × 10 ft slab that is 4 in thick contains 10 × 10 × (4 ÷ 12) = 33.33 ft³, or about 1.235 yd³ (0.944 m³) before allowance. If you apply 5% allowance, the required quantity becomes roughly 1.296 yd³. A supplier may require a larger order because it sells in fixed increments; that is a purchasing rule, not additional measured concrete.
For reliable results, measure the formed or excavated shape, confirm that thickness is consistent, check the selected units beside every field, and use drawings where available. The final result is a planning estimate, not a structural quantity certification.
Can I calculate several slabs, footings and columns in one concrete order?
Yes.
Give the project a name, then add one section per distinct pour. Choose the geometry that matches each part: rectangular slabs and footings, round columns and post holes, hollow rings, solid steps, curb/gutter, or a known volume. Enter Quantity when several pieces genuinely share the same dimensions, and give sections descriptive names such as “Garage slab,” “Front footing × 6,” or “Service opening.”
Use Add concrete for solid pours and Deduction / void for openings that occupy space already included in another section. For example, if a slab opening is already excluded from your measured length and width, do not subtract it again. If six column bases are the same, enter one round section with Quantity = 6 rather than copying it six times.
The table in the Concrete Order Summary lists all sections with their quantities and add/deduct roles. Review that list carefully. A project with an incomplete section must not be treated as a finished order—fill in or remove the unfinished section first.
How many cubic yards of concrete do I need?
Divide cubic feet by 27: a 10 × 10 ft slab 4 in thick is 33.3 ft³, or about 1.23 cubic yards.
A cubic yard is a volume, not an area. One cubic yard = 27 cubic feet ≈ 0.7646 cubic metres. For measurements in feet, convert every thickness in inches to feet before multiplying: cubic yards = length(ft) × width(ft) × thickness(ft) ÷ 27. For centimetres or millimetres, convert to metres, then multiply for cubic metres.
Example: a 12 ft × 15 ft patio at 5 in thick contains 12 × 15 × (5 ÷ 12) = 75 ft³ = 2.778 yd³ before allowance. At a 5% allowance, the required quantity is 2.917 yd³. If your supplier rounds to 0.25 yd³, the suggested rounded order would be 3.00 yd³, assuming no separate supplier minimum.
The calculator retains the unrounded net volume, the allowance and the supplier-rounded recommendation as separate figures. That separation helps explain why the number on an order ticket may be larger than the calculated physical need. Verify the supplier’s actual increment before placing the order.
How many bags of concrete do I need?
Divide the volume you need by the mixed yield per bag shown on the label; an 80 lb bag typically yields about 0.6 ft³ (0.017 m³).
Do not calculate bags using bag weight alone. Look for the manufacturer’s mixed concrete yield per bag on the product label or data sheet. Enter that yield in the bag settings using the matching unit, and specify the product’s bag weight and price separately. Required bags = required mixed concrete volume ÷ actual yield per bag; always round upward to a whole bag. The calculator displays the rounding surplus so you can see how much extra mixed volume the whole-bag purchase creates.
Example: if a small pad requires 9.5 ft³ including allowance, and the selected bag yields 0.60 ft³, you need 9.5 ÷ 0.60 = 15.83, therefore 16 bags. Their approximate total yield is 9.6 ft³. A different brand or formulation may yield differently even if the bags weigh the same, so use its actual stated yield. The common US bag-size comparison is a guide, not a replacement for your product information.
Also consider lifting, water supply, mixer capacity, working time and access. For larger pours, compare the bag price and labour with a ready-mix quote. See the bag comparison photo below the calculator.
How much extra concrete should I order?
Most people add 5–10% for uneven ground, form variation and spillage.
The allowance covers practical uncertainty beyond the ideal geometry: uneven ground or excavation, small form differences, measurement error and placement losses. It is separate from the supplier’s order increment and separate from the surplus created by rounding up premix bags. Do not confuse any of those three quantities.
Suppose the measured net volume is 2.00 m³ and you choose a 5% allowance. The allowance is 0.10 m³, so the required quantity is 2.10 m³. A supplier that sells in 0.25 m³ increments might quote 2.25 m³. The 0.15 m³ difference from 2.10 to 2.25 is supplier rounding, not another 5% allowance. If your measured inputs already include a deliberate construction margin, avoid adding that same margin twice.
There is no universally correct allowance for every site. A tightly formed, predictable pour differs from an irregular excavation or a pump-delivered pour. Use a documented site estimate or supplier guidance, and check that the allowance is appropriate before relying on the purchase quantity.
Why is supplier-rounded order different from required concrete?
Because suppliers round orders up to set increments or minimum loads, so the order can be larger than the concrete the job needs.
CalcTypes shows a sequence: net measured volume → allowance → concrete required → supplier order volume. The first three describe the job. The last is influenced by optional business rules such as the minimum quantity a plant will deliver and the increments in which it accepts orders. Those policies vary by supplier; they are not universal engineering formulas.
Example: if the job requires 1.18 m³, and the supplier permits ordering only in 0.25 m³ increments, the rounded order is 1.25 m³. If that same supplier also insists on a minimum physical order of 1.5 m³, then 1.5 m³ is the relevant order quantity (assuming it is an allowed increment). A supplier’s minimum billed volume, short-load fee or delivery charge may be a separate commercial rule and should not be inferred from the minimum physical delivery.
Request the exact rules and quote from your supplier. Keep required quantity, actual quantity ordered, transport loads and cost separate so that you do not mistake a pricing or logistics requirement for additional concrete in the structure.
How does the stairs calculation work?
The stairs mode models a solid, filled stepped concrete shape.
Enter the stair width, the horizontal tread/run per step, the vertical riser height, and the number of steps. Each successive step occupies more concrete below it. For equal treads and risers, the stepped volume is width × tread × riser × n(n+1)/2, where n is the number of steps. The optional top-platform depth adds a rectangular block at the full stair height.
Example: for 3 solid steps, each 1.0 m wide, 0.30 m run and 0.15 m rise, the stepped portion is 1.0 × 0.30 × 0.15 × (3 × 4 ÷ 2) = 0.270 m³ before allowance and before any platform. Measure the actual formwork rather than relying on a nominal stair name.
Important: suspended stairs, stairs with a sloping waist slab, open space beneath, landings or complex profiles may need a different takeoff. Do not represent their volume using the solid-step formula without checking the approved design. See the step-formwork photo.
Can this calculator estimate cement, sand and aggregate?
Yes, through the optional site-mix material estimate.
It is for preliminary quantities of cement, fine aggregate (sand), coarse aggregate and water, not for certifying a structural mix. Select the site-mix option and enter the nominal/example proportions or approved proportions that apply to your job. The calculator estimates dry ingredient volume by multiplying the wet concrete requirement by a chosen dry-volume factor, then allocates that volume among the specified parts.
For illustration, if the required wet concrete volume is 1.00 m³ and the selected dry-volume factor is 1.54, the estimated total dry ingredient volume is 1.54 m³. Under an illustrative 1:1.5:3 parts ratio (5.5 parts total), the preliminary volumes are approximately 0.280 m³ cement, 0.420 m³ sand and 0.840 m³ aggregate. Cement mass is then estimated using a bulk-density assumption; actual supplies and moisture contents can change the result.
The water estimate based on water–cement ratio is only a planning indication. Never use these simple volumetric proportions to replace the approved strength, durability, exposure and workability requirements for structural concrete. See the materials illustration.
Can I use a fixed nominal ratio for M25 or M30 concrete?
No. A grade such as M25 or M30 specifies strength, so its mix proportions must come from a proper mix design rather than a fixed ratio.
No—not as a universal engineering rule. A concrete grade describes a specified strength requirement, not a unique guaranteed recipe of “cement : sand : aggregate.” The strength and durability achieved depend on cement and aggregate properties, water–cement ratio, moisture, admixtures, grading, compaction, curing and project specifications. A ratio copied from a website may not perform the same way with different local materials.
For higher-grade structural concrete such as M25 or M30, obtain the approved design-mix proportions and specification from the project engineer, qualified laboratory or ready-mix supplier. The previous calculator’s simple nominal examples should not be interpreted as engineering-certified designs. The CalcTypes site-mix output is a material-planning estimate only.
If you only need to know how much concrete fills a footing or slab, you can calculate the geometric quantity without entering any mix proportions. Then use that required volume to request a supplier quote for the specified grade and performance, rather than deriving the structural mix from a basic volume calculator.
When should I use bags instead of ready-mix concrete?
Bags suit small jobs with easy access, roughly under one cubic yard; ready-mix is better for larger pours that must be placed in one go.
Bagged concrete is often practical for small jobs with easy access, manageable mixing batches and limited placement time. Ready-mix can be more practical where a consistent large volume must be placed quickly. Neither route is always cheaper: the answer depends on local supplier pricing, bag yield, transport, labour, mixer availability, site access and any short-load or delivery fees.
Use the same required concrete volume to compare the two alternatives. For bags, enter the correct mixed yield and price per bag, then use the whole-bag count and bag cost. For ready-mix, enter the supplier’s price per cubic yard or metre and any applicable order increment or delivery minimum. Check that both options meet the specified concrete grade and intended application.
For example, a tiny post repair could require only a few bags, while a garage slab may involve enough bags to create significant handling and timing issues. If the job requires continuous placement or specified structural concrete, verify the placing plan and approved mix before choosing based solely on the displayed cost.
Which shape should I choose for a circular slab, hollow column, ring or ramp?
Choose by the space the concrete fills: a circular slab is a short cylinder, a hollow column or ring is a tube, and a ramp is a wedge.
Choose the shape based on the space filled by concrete, not just the everyday name of the structure. A circular solid slab or disk is mathematically a short solid cylinder: select “Round column / pier / post hole,” enter the full diameter, and enter the slab thickness as Height / depth. A hollow circular ring uses “Tube / ring”; it requires both the outside diameter and the opening’s inside diameter. A rectangular slab is a simple box, and a post hole can be modelled as a solid round volume if concrete fills the entire hole.
If the concrete surrounds an inserted post, you may need to deduct the post’s displaced volume from the gross filled-hole volume where that displacement is significant and actually occurs. Do not deduct an empty opening twice.
Ramps: not every ramp is a full rectangular slab. Some have a triangular or variable-thickness wedge; others contain voids or structural features. The current calculator does not provide a dedicated ramp geometry, so use a verified volume from plans in “Known concrete volume” instead of pretending a standard slab formula fits every ramp. Future ramp functionality can be added only after the geometry is defined and tested.
How do I check the final concrete order and save it for the supplier?
Start at the Concrete Order Summary at the end of the calculator.
Verify that every intended pour appears exactly once, that deductions are appropriate, and that the net volume plus allowance matches your project plan. Then decide whether you are purchasing ready-mix, premix bags, or a deliberately mixed combination; the ready-mix quantity and bag quantity are alternative ways to supply the same required concrete volume, not amounts to add together automatically.
For ready-mix, confirm the supplier’s accepted increment, minimum physical order, grade, price unit, truck capacity, access and delivery charges. For bags, match the product label, stated mixed yield, bag size and bag price. Check any material-mix output only against approved proportions.
Use Copy order summary for a text checklist, Print / Save PDF for a compact project report, or the exact project link and QR to reopen the entered measurements. The PDF uses the browser’s print dialog: choose “Save as PDF.” If the report does not open, first make sure every section is complete and that browser printing is permitted.
Methodology & formulas
Geometry
- Rectangular: V = length × width × depth.
- Round solid: V = π × (diameter ÷ 2)² × height.
- Tube / ring: V = π × [(OD ÷ 2)² − (ID ÷ 2)²] × height.
- Solid steps: V = width × tread × rise × n(n+1)/2, plus optional platform depth × total stair height × width.
- Curb + gutter: curb section + gutter/flag section along the entered length.
Ordering sequence
Added sections − deductions = net measured volume. Allowance is then added. Supplier increment/minimum is applied only afterward, so purchasing rules never change the underlying measured need.
Bags
Whole bags = required volume ÷ manufacturer-stated mixed yield per bag, rounded up. Bag weight is used only for handling/total dry weight, not to infer yield.
Site-mix materials
Optional material quantities use the selected parts and dry-volume factor. Cement mass uses an estimating bulk density of 1440 kg/m³. Real mix design depends on materials, grading, water, admixtures, exposure, workability and performance requirements.
Important Disclaimer
Planning and educational estimates only. CalcTypes is a calculation aid, not a survey, engineering design, specification, safety assessment, construction instruction, quality certification, or guarantee that your purchase quantity will be sufficient. Results are based entirely on the information entered and on stated assumptions. Errors in measurement, units, geometry, voids, material yield, site conditions, calculation inputs or supplier practices can cause shortages, surplus material, cost overruns and construction defects.
You are responsible for independent verification. Before ordering, mixing, placing or building, check all measurements and actual site conditions; validate the mix grade, strength and exposure requirements; confirm bag yields, supplier ordering/billing rules and prices; and obtain review and approvals from qualified engineers, contractors, local authorities and suppliers whenever appropriate. Do not use this calculator as the sole basis for structural or safety-critical decisions.
No professional relationship or warranty. Information is provided on an “as available” basis for general planning, without a promise of accuracy, completeness, suitability or fitness for a particular project. To the extent permitted by applicable law, CalcTypes does not accept responsibility for losses arising from reliance on unverified estimates, including material shortage, over-ordering, delays, damages or improper construction. Nothing here excludes liability that cannot lawfully be excluded.
Read our full website disclaimer: CalcTypes Disclaimer. This notice should be reviewed alongside your site’s legal terms by a qualified adviser; wording alone does not guarantee legal protection.
